Emerald Blog

Stories, Tips And Tricks From Our Team’s Experiences With Primavera Since 1995

14 January 2019

EP-Dashboard - Tracking Found Work on Turnarounds Made Easy

Written by Sue Hopkins - Implementation Specialist

While working on a turnaround project where our client was using our EP-datawarehouse and EP-dashboard tools for the first time, we were already showing them green up reports, inspection summary reports, performance curves and productivity curves, but had been tweaking them to fit their needs during the turnaround, which was quite beneficial to their team.

I was providing assistance to the turnaround team and started entering Additional Work Requests (AWR’s) as they came in from the AWR manager. The process required several steps during its life and we found a dashboard would be helpful in keeping track of the process, since we were getting questions about where AWR's were in the process. An AWR entered the process when it was received from the field personnel, assigned a number and entered into a master spreadsheet by the AWR manager. The spreadsheet listed several pieces of information, but the information we needed for the dashboard was the AWR#, Date Submitted, Approval Status, and the Description.

When the AWR was approved, it was sent to the schedulers to enter a placeholder into the schedule. After the placeholder was entered, a planner would enter the necessary activities and resources for the AWR. The activities would then be started and completed just like an original activity.

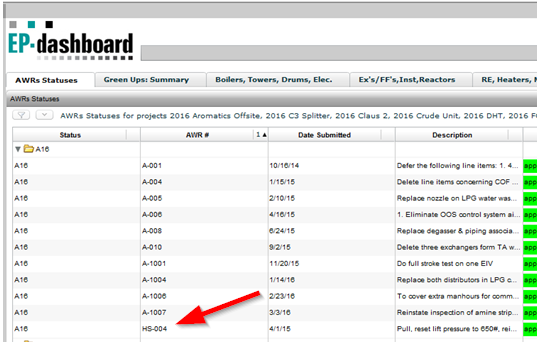

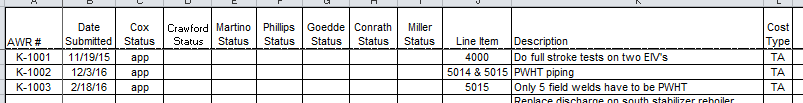

My IT colleague was able to use data from the master Excel spreadsheets and data that was snapshotted daily using the EP-datawarehouse from P6 to create the EP-dashboard below. The dashboard shows the AWR’s by project and using the snapshot data, indicates whether the AWR had been approved, if the placeholder activity was entered in P6, if the AWR had been planned and if so, if the activities had been started and/or completed. The creation of the dashboard took less than a day.

By using this newly created dashboard, we quickly discovered there were errors in several projects, where the AWR numbering schema did not match the project it was entered into.

We were able to correct all the errors concerning AWR’s that had previously existed, sometimes for over a year, within a day. We were not only able to create an extremely helpful dashboard, but we also improved the data integrity of the projects.

06 December 2018

Large XER Files do not play well with P6 Import and Export

Written by Sue Hopkins - Implementation Specialist

Are you finding when you are importing or exporting a large number of projects that not all the projects are coming across when they are imported?

While converting a client from P6 V8.3 to V15.2, we found the data was not always transferred completely when we migrated large numbers of projects. Instead, with XER file sizes larger than 100,000 KB not all projects were exported and/or imported. We confirmed this recently on a subsequent project with a different client where we were migrating projects from P6 V7.3 to V17.12 and encountered the same issue.

In the first case, we exported the projects using an XER. Our file was over 300,000 KB. We found 4-5 projects were not exported. When we imported the same file, there were 2-3 additional projects that were not imported to the new database.

We looked at additional files for the same client and found that in XER files with a size larger than approximately 100,000 KB there were several projects in each XER missing when the file was imported.

Once we reduced the number of projects in the exported XER files to keep the file size under 100,000 KB, we found no projects were lost and our data was accurate.

Keep an eye on XER files larger than 100,000 KB when importing and exporting, they may not have complete data in them once they are imported.
